XEPIAN-XENAMNOY HYDROPOWER PROJECT

Call Us Now (865-21)263805-06

XEPIAN-XENAMNOY HYDROPOWER PROJECT
PROJECT BACKGROUND

1 Project Location.

The Xepian-Xenamnoy HydroPower Project is located in the 2 Provinces: Champasak and Attapeu on the southern of lao PDR. As part of this 410 MW, one river diversion and two dams shall be constructed across the following three rivers: Houay Makchane, Xe Pian- Xe namnoy. The scheme’s main dam and other major structures will be located in Champasak Province. while the proposed powerhouse, tailrace channel and high voltage transmission line located in Attapu Province In 1995, a feasibility study for this project was already carried out.

2. Project Rationale

the Project is expected to generate 1,879 Gwh per year. The Project will export 90% of the electric power it generates to Thailand under a Power Purchase Agreement between the Electricity Generating Authority of Thailand and the PNPC, while the remaining 10% will be sold to the local grid under a Power Purchase Agreement between the PNPC and the Electricite du Laos. The Project will operate and manage the Project during the 27-years Concession Period after the 5-years Construction Period and commencement of commercial operations by 2019. After the expiry of the Concession Period, the PNPC will transfer the Operations and Management of the Project to the Government of Laos.

3. Project History

Joint Development Memorandum of Understanding (MOU). between SK Engineering Construction (SKEC) and Korea Western Power Co.,Ltd (KOWEPO) on the date july 19, 2005. Memorandum of Understanding (MOU) With Government of Lao PDR (GOL)on August 3rd, 2006. Foreign Investment Application Submitted to Government of Lao PDR. Memorandum of Understanding between Government of Lao PDR (GOL) and the Consortium SK Engineering Construction (SKEC) and Korea Western Power Co.,Ltd (KOWEPO) Consortium Representative Office in Lao on 25 May 2007.
Development Cost Sharing SKEC:KOWEPO: RATCH = 34%: 33%:33%.The Feasibility Study Approval From Government of Lao PDR. On 4 January 2008.
Completion of Project Development Agreement(PDA) Negotiation With GOL On 16 February 2008.
Presentation to Electricity Generating Authority of Thailand (EGAT) for Technical Aspects on 14 May 2008
The Project Development Agreement (PDA) Signed for 18 month on 14 November 2008.
Proposed Tariff to Electricity Generating Authority of Thailand (EGAT) on 20 February 2009.
The Shareholders’ Agreement is signed by all major Shareholders on 15 June 2011.
The Concession Agreement between PNPC and the GOL is signed on 19 October 2012.
The Financial Closed with Lenders and Initial Drawdown on 6 February 2014.
The PNPC-EDL Power Purchase Agreement is signed on 10 May 2013.
The PNPC-EGAT Power Purchase Agreement is signed on 6 February 2013.

PROJECT TECHNICAL DESCRIPTION XE PIAN-XE NAMNOY
XE PIAN-XE NAMNOY HYDROELECTRIC POWER PROJECT
Technical Description
br>Technical Description

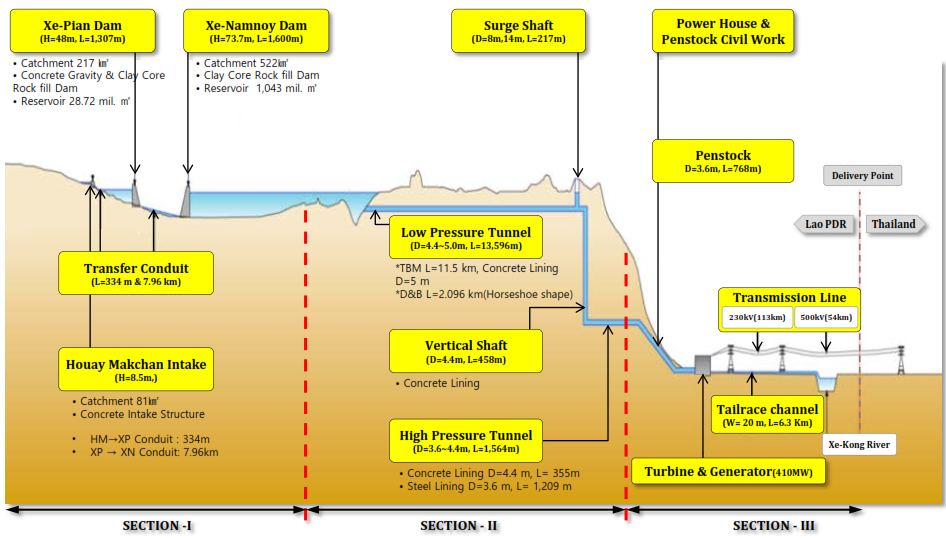

. Dam and Intake Structure


Dam Type
Max. Height(m)
Length(m)
Catchment’s Area (Km2)
Reservoir Capacity(mil.m3)
Reservoir Area (Km2)
Max. Height(m)
Xe Namnoy
Rockfill
75.5
1.430
522
1092
50
25.0
Xe Pian
Rockfill
47.0
1.250
217
24
3
10.9
Houay Machan(Intake Structure)
Concrete Structure
8.5
-
81
-
-
4.3

Headrace and Powerhouse
Headrace Tunnel (a) Total Length: 16.1 km (b) Max Gross Head: 691m
Upper Tunnel
L = 13.6 km, D = 5.2 m
Vertical Shaft
L = 0.5 km, D = 4.6 m
Lower Tunnel
L = 1.7 km, D = 3.6 ~ 4.6 m
powerhouse
Turbine
3 x Francis Type
3 x Francis Type
(3 x 130 MW) + 2.5 MW = 392.5 MW
